For the latest version of JMP Help, visit JMP.com/help.


Publication date: 07/24/2024

Statistical Details for Individual Observations

You can use the Multivariate Control Chart platform to analyze individual observations, or measurements that are not sub-grouped. For these types of measurements, the natural subgroup size is n = 1. Denote the number of observations by m and the number of variables measured by p. A T2 statistic is calculated and plotted for each observation. The calculation of the T2 statistic and upper control limit (UCL) depends on the source of the target statistics. In a Phase I chart, the limits are based on the same data that is being plotted on the control chart. In a Phase II chart, the limits are based on target statistics that were calculated from a historical data set. For more information about T2 statistic and control limit calculations for Hotelling T2 control charts, see Montgomery (2013).

Calculations for Phase I Control Charts

In Phase I control charts, the T2 statistic for the ith observation is defined as follows:

Equation shown here

where:

Yi is the column vector of p measurements for the ith observation

Equation shown here is the column vector of sample means of the p variables

S-1 is the inverse of the sample covariance matrix

The Ti2 value for each of the i observations are the points plotted on the multivariate control chart.

When computing Phase I control limits, the UCL is based on the beta distribution. Specifically, the upper control limit (UCL) is defined as follows:

Equation shown here

where:

p = number of variables

m = number of observations

Equation shown here = (1–α)th quantile of a Beta Equation shown here distribution

Calculations for Phase II Control Charts

In Phase II control charts, define the historical data set as X. Then the T2 statistic for the ith observation is defined as follows:

Equation shown here

where:

Yi is the column vector of p measurements for the ith observation

Equation shown here is the column vector of sample means of the p variables, calculated from the historical data set

SX-1 is the inverse of the sample covariance matrix, calculated from the historical data set

The Ti2 value for each of the i observations are the points plotted on the multivariate control chart.

When computing Phase II control limits, new observations are independent of the historical data set. In this case, the upper control limit (UCL) is a function of the F distribution and partially depends on the number of observations in the historical data set from which the targets are calculated. The UCL is defined as follows:

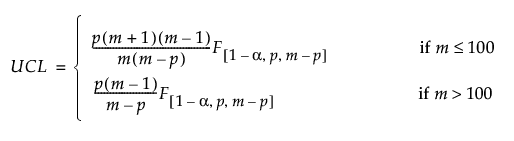

Equation shown here

where:

p = number of variables

m = number of observations in the historical data set

Equation shown here = (1–α)th quantile of an FEquation shown here distribution
